When I discuss production schedules with global B2B buyers, I often emphasize one simple truth: lead time is not a fixed number—it’s a controlled variable shaped by your order strategy. In most cases, the standard production lead time for inflatable gymnastics mats from China falls between 7 and 25 days, but the real picture depends heavily on the scope of your project.
For example, small trial orders with standard sizes typically finish within 7–12 days, while bulk procurement programs involving tailored designs, multi-color branding, or high-volume seasonal stocking patterns usually take 15–30 days. What I’ve learned from managing countless orders is that factories with stable raw-material reserves and well-regulated workflows consistently deliver shorter, more predictable timelines.
B2B customers—especially wholesalers, gyms, schools, and sports retailers—care deeply about timeline reliability because their downstream commitments (inventory cycles, class schedules, promotion calendars, container consolidation deadlines) depend on the factory’s operational discipline. That’s why understanding lead time isn’t just “nice to know”—it’s part of your supply-chain strategy.

When I work with procurement managers, distributors, and gym equipment brands, one thing becomes clear immediately: production lead time is not only about how fast a factory can make inflatable gymnastics mats—it’s about how predictably your entire business can operate.
For B2B buyers, timing impacts everything. If I’m scheduling a seasonal stock rollout, planning a retail promotion, or aligning shipments with container consolidation, even a three-day delay can disrupt the downstream chain. Inflatable gymnastics mats, in particular, have a strong demand cycle tied to school semesters, gymnastic club enrollments, franchise expansion, and sports-event planning. That means your purchasing window is narrow, and misalignments directly translate into lost sales or operational bottlenecks.
I’ve seen brands that place orders too close to their launch date end up paying premium air freight just to avoid empty shelves—an avoidable expense. I’ve also worked with wholesalers whose margins tightened simply because production didn’t match the rhythm of their distribution cycle. This is why understanding and negotiating realistic lead times becomes part of your risk-management strategy, not just procurement.
When importing inflatable gymnastics mats from China, you’re not simply purchasing a product—you’re securing a timeline that must synchronize with warehousing, marketing, distribution, and end-customer expectations. And the more accurately I plan this timeline with my suppliers, the smoother the entire business runs.

Whenever I plan a production schedule for inflatable gymnastics mats from China, I remind my buyers that lead time is the outcome of multiple moving parts—not just factory speed. If I understand these variables early, I can forecast more accurately, negotiate smarter, and avoid unpleasant surprises. Below are the four major elements that shape your actual production time.
For inflatable gymnastics mats, the heartbeat of production lies in PVC drop-stitch fabric and reinforced coating materials. When the factory maintains strong supplier contracts and stable material inventory, lead time remains smooth.
But during peak season—or when upstream suppliers tighten capacity—material replenishment can take an additional 3–7 days. I’ve seen this happen especially in Q2 and Q4 when sports equipment orders surge globally.
If a supplier lacks raw-material stock, even the most efficient production line can’t begin—so I always verify their material reserve strategy before placing larger orders.
Order size is one of the biggest determinants of speed. A batch of 20 standard mats can move through a production line quickly. But when a buyer requests:
the production flow becomes more segmented.
Customization introduces more checkpoints—artwork confirmation, color matching, printing setup—which can add 2–5 days if not approved promptly. This is why I always push clients to finalize specifications early, or use structured solutions such as customize air tracks to streamline the personalization workflow.
Chinese sports-equipment factories run on a predictable but intense cycle. Peak months (usually April–July and September–November) are filled with wholesale orders, school tenders, and franchise expansions.
During these windows, even a well-organized manufacturer may require an extra 3–10 days simply because multiple large orders are queued ahead of yours.
This is why I always ask for:
A transparent factory reduces uncertainty; a vague one multiplies risk.
Inflatable gymnastics mats require strict QC procedures—especially the 24–48-hour pressure-holding test that ensures no microscopic leaks.
These QC steps are non-negotiable for B2B buyers, particularly for brands selling to gyms and training centers where safety is everything.
Even if production is fast, QC cannot be rushed. In my experience, a factory with disciplined QC actually shortens overall lead time because fewer products fail post-production checks.

When I discuss production timelines with my clients, the most common question I hear is: How long does it actually take to produce a batch of inflatable gymnastics mats? The answer isn’t a simple one-size-fits-all, but it’s important to break it down by order size and specific requirements.

| Order Size | Order Description | Typical Production Time |
|---|---|---|
| Small Orders | 1–20 pcs; sample runs; trial orders | 3–7 days |
| Medium Orders | 50–200 pcs; standard wholesale | 7–12 days |
| Large Orders | 500–1000+ pcs; brand/retailer inventory | 12–20 days |
By understanding these timeframes, you can better plan your procurement strategy. For instance, if you’re preparing for a new gym season or an upcoming event, it’s crucial to place your order early enough to allow for customization and shipping. In my experience, I recommend planning for a minimum of 15–20 days for most medium to large orders, particularly if you're including customized air tracks or other personalized features.
The best practice I follow with clients is to ensure we have a clear production timeline outlined with the manufacturer, and that we account for potential delays by allowing a bit of buffer time for quality control and unforeseen circumstances.
When I help procurement teams plan their purchasing cycles for inflatable gymnastics mats, I always emphasize one point: production delays rarely happen without a reason. In China’s manufacturing ecosystem, delays can typically be traced back to a handful of predictable factors. Once I understand these variables, I can anticipate risks and build a timeline that protects my downstream operations.
Below are the most common causes I encounter during real-world B2B sourcing:
| Cause | Why It Happens | Possible Delay Added |
|---|---|---|
| Raw Material Shortages | Drop-stitch PVC or accessories unavailable | +3–7 days |
| Artwork/Customization Delays | Incorrect files, unclear Pantone, late approval | +2–5 days |
| Factory Overload (Peak Season) | Large queue during April–July & Sept–Nov | +3–10 days |
| QC Rework | Seam issues, air retention failure, valve problems | +1–3 days |
| Last-Minute Order Changes | New sizes, new logos, new colors | +1–4 days |
| Logistics Constraints | Container shortage, port congestion, customs | Unpredictable |
When I work with international procurement teams importing inflatable gymnastics mats from China, the first thing I emphasize is this: production time is not fixed—it’s negotiable, manageable, and optimizable.
Over the years, I’ve learned that the fastest lead times usually come from smart preparation, not from factory pressure.
Below are the strategies I consistently use to shorten production cycles without sacrificing quality.
| Strategy | Why It Speeds Up Production | Time Saved |
|---|---|---|
| Finalize specs before PO | Prevents multiple revision cycles | 2–4 days |
| Approve artwork quickly | Allows printing to start immediately | 1–2 days |
| Choose factories with raw-material inventory | No waiting for PVC/drop-stitch supply | 3–7 days |
| Avoid peak seasons | Shorter queue, more staff availability | 3–10 days |
| Request dedicated production line | Prioritized workflow for your order | 3–6 days |
| Maintain real-time communication | Issues solved before they escalate | 1–2 days |
| Select automated factories | Faster cutting/bonding, fewer defects | 2–4 days |

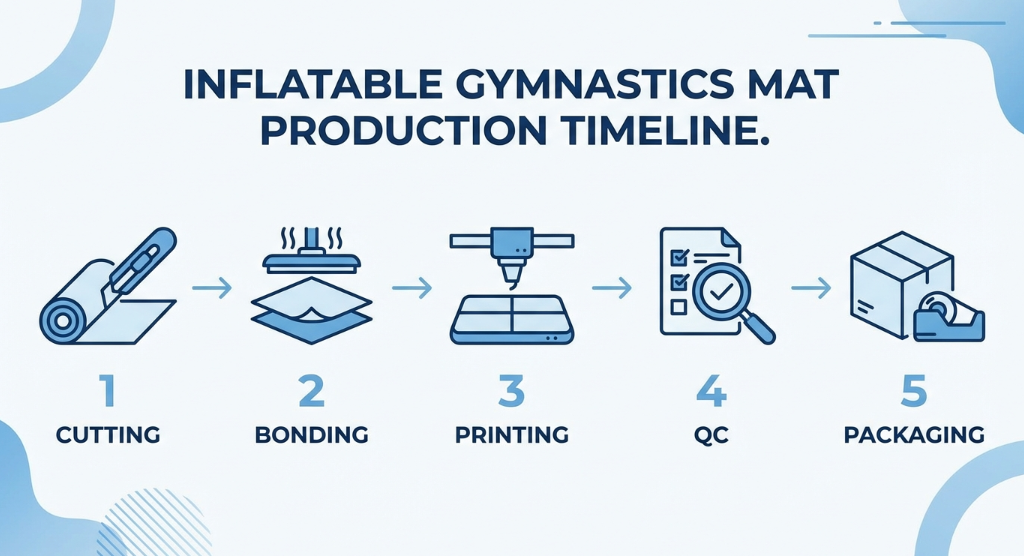

When an order of inflatable gymnastics mats is delayed during production, it can be frustrating—but it's crucial to stay calm and act strategically. From my years of experience managing B2B orders, I’ve learned that most delays can be mitigated with the right communication and planning. Below, I’ll share the most effective steps to take when your order doesn’t arrive on time.
| Step | Action | Purpose |
|---|---|---|
| 1 | Request updated timeline (Gantt chart) | Identify bottlenecks and new ETA |
| 2 | Ask for QC photos/videos | Confirm delay reason & verify product status |
| 3 | Adjust shipping method if needed | Minimize overall delivery impact |
| 4 | Request partial shipment | Keep some inventory flowing |
| 5 | Increase communication frequency | Prevent secondary delays |
| 6 | Use 3rd-party inspection if unclear | Improve transparency |
| 7 | Negotiate compensation if applicable | Protect financial impact |
Over the years working with global buyers of inflatable gymnastics mats, I’ve learned that lead time stability isn’t luck — it’s the result of partnering with the right manufacturer. When I choose a factory with proven systems, my production becomes more predictable, my logistics window becomes tighter, and my downstream operations run with far fewer disruptions. Below, I break down the reasons why a trustworthy manufacturer dramatically improves lead time reliability.
A reliable manufacturer operates with well-defined Standard Operating Procedures (SOPs) at every stage: cutting, bonding, printing, QC, packaging, and pressure testing.
When a factory follows strict SOPs:
In my experience, the factories that deliver the fastest lead times aren’t necessarily the ones with the largest workforce—they’re the ones with the most disciplined processes.
One thing I always look for is whether the factory uses modern tools like:
| Equipment Type | Benefit | Lead Time Impact |
|---|---|---|
| Automated cutting | Higher precision, less rework | −1–2 days |
| Digital printing | Faster logo application | −0.5–1 day |
| Heat-press bonding | Stable seams, fewer QC failures | −1–2 days |
For B2B procurement, technology isn’t a “nice to have”—it’s a guarantee of consistency.
Factories with long-term partnerships with raw-material suppliers don’t scramble for PVC drop-stitch fabric or valves when peak season hits. They maintain buffer stock, which eliminates the typical 3–7 day raw-material delay.
| Strength | What It Means | Lead Time Impact |
|---|---|---|
| Strong material partnerships | Guaranteed drop-stitch PVC stock | Avoids +3–7 day delay |
| Multi-supplier backup | Material redundancies | Reduces risk of stoppage |
| Local accessory suppliers | Faster valve/handle restock | Saves 1–3 days |
That’s how I know they can keep my lead times consistent.
A trustworthy manufacturer keeps me updated without me needing to chase them. I receive:
This transparency allows me to adjust my logistics schedule and avoid unpleasant surprises.
When transparency is part of the culture, delays shrink, and predictability increases.
Good manufacturers assign experienced project managers who understand:
When communication is centralized through a skilled PM, I avoid misinterpretations and delays.
This is especially important when coordinating customization, such as projects using customize air tracks.
Factories with consistent QC schedules—like 24–48-hour pressure tests and seam checks—avoid last-minute surprises.
Quality becomes predictable, and so does timing.
A bad factory rushes QC.
A great factory controls QC.
A trusted factory plans QC into the timeline, giving me dependable delivery windows.

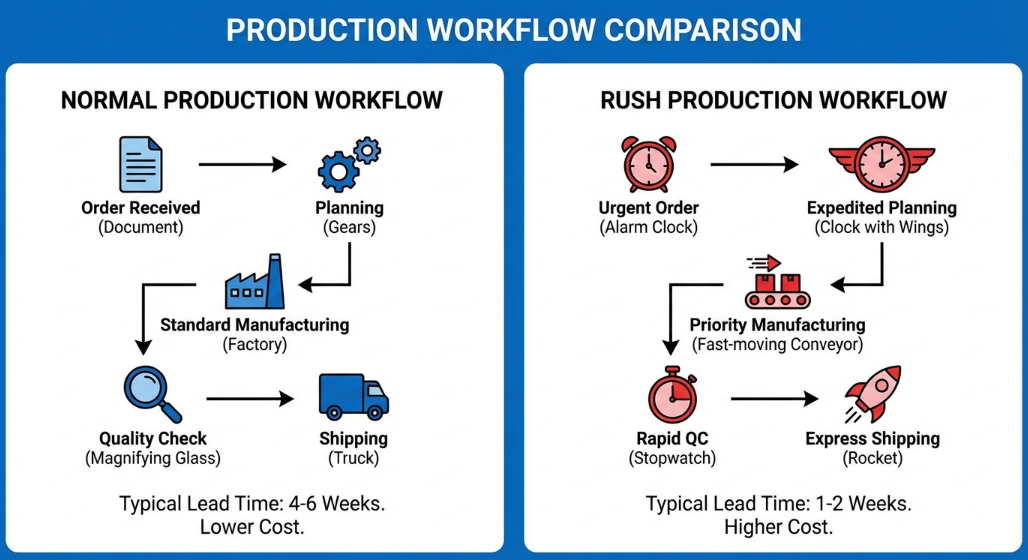

When B2B buyers ask me whether they should request rush production, I always give the same advice:
Rush production is a strategic tool—not a default option.
It can save your season, protect your retail window, or rescue a delayed campaign—but only when used wisely. Below, I break down exactly when it makes sense and what you should expect from factories when you request it.
There are several situations where I recommend activating rush production for inflatable gymnastics mats:
In these cases, paying a modest rush fee is far cheaper than losing an entire sales cycle or upsetting institutional clients like schools and training centers.
Many buyers assume “rush production” simply means “make it faster,” but from the factory’s viewpoint, it usually means:
| Factory Adjustment | How It Speeds Up Production |
|---|---|
| More workers assigned | Faster stitching & bonding |
| Order placed at front of queue | Immediate processing |
| Extended shift hours | Higher daily output |
| Use of reserved materials | No waiting for inventory |
| Compressed workflow steps | Reduced idle time |
Factories rarely compromise on quality—especially not the 24–48-hour pressure test, which cannot be skipped. Rush production compresses workflow, not quality control.
When handled properly, it can shorten lead time by 3–7 days, depending on your order size.
There are moments when I advise clients not to request rush production, such as:
| Situation | Rush Production? | Reason |
|---|---|---|
| Branding not finalized | ❌ No | Leads to rework delays |
| Peak season full capacity | ❌ Limited | Factory cannot expand beyond physical limits |
| Shipping schedule fixed | ❌ No benefit | Production speed doesn’t affect overall ETA |
| Highly customized order | ⚠ Maybe | Complex specs require slower QC |
| Buyer wants speed but not additional cost | ❌ No | Rush requires resources |
In these cases, forcing a rushed timeline often causes communication mistakes, rework, and more delays, not fewer.
In B2B procurement, relationships matter.
I negotiate rush production by focusing on mutual benefit rather than pressure.
Here’s what I typically say:
Factories respond far better when they see stability, not urgency.
Strategic partnership always beats transactional demands.
Even the fastest manufacturer cannot break physics:
Rush production accelerates workflow, not material science.
This distinction is what keeps your inflatable gymnastics mats safe, durable, and compliant with international standards.
When I work with international buyers—especially wholesalers, gym chains, and sports brands—the discussion often moves beyond “just the product” and into the world of brand identity. Inflatable gymnastics mats are not simply functional equipment; they’re a visual extension of your business.
But what many buyers overlook is that every branding decision directly influences production lead time—sometimes by a few hours, sometimes by several days.
Understanding where to place your branding and how to integrate custom specs helps me optimize production flow while keeping your marketing vision intact.
| Custom Element | Description | Lead Time Impact |
|---|---|---|
| Logo – top surface | Requires stronger adhesion, curing | +1–2 days |
| Logo – sidewall | Faster, less curing required | < 1 day |
| Pantone color matching | Requires color testing | +1–2 days |
| Multiple color zones | Additional lamination steps | +1–3 days |
| Extra handles / D-rings | Manual installation | +1–3 days |
| Retail packaging (printed cartons) | External printing supplier needed | +5–7 days |
| Standard packaging | Plain boxes or stickers | No delay |
| Non-standard sizes | New templates & bonding adjustments | +2–4 days |
| QR/NFC tags | Small integration & QC check | +0.5–1 day |
When I advise B2B buyers on choosing the right supplier for inflatable gymnastics mats, I consistently prioritize factories that offer a structured, system-based customization process — especially those built around solutions like customize air tracks.
Why?
Because in real procurement, customization isn’t only about “making the product look like your brand.” It’s about controlling lead time, reducing rework, protecting consistency, and minimizing supply-chain risk.
And honestly — a factory with an organized customization system just makes my job feel smoother.
Traditional customization relies on scattered emails and PDF exchanges, which often leads to:
With customize air tracks, all of this becomes centralized and visual:
This alone typically saves 1–3 days before production even begins.
In B2B timelines, that time difference can decide whether you meet or miss a seasonal sales window.
A professional customization system stores all brand files in one place, including:
This eliminates the classic, time-killing scenario:
“Did you send the final version? I can’t find it.”
When every department in the factory pulls from the same source, mistakes drop dramatically — and so do unnecessary delays.
Factories without structured systems operate reactively:
“Let me check with the printing team.”
“We’re waiting for the design confirmation.”
“We need to adjust the template again.”
Factories with customize air tracks operate proactively:
“All assets are uploaded.”
“Templates are synchronized with production.”
“QC will follow the preset standard checklist.”
Consistency drives predictability — and predictability drives stable lead time.
Most production delays come from customization errors like:
A proper customization system ensures:
This dramatically lowers rework, which often causes 3–7 days of avoidable delay.
For wholesalers, gym franchises, and international distributors, consistency is a form of currency.
customize air tracks helps maintain uniformity across batches by standardizing:
Consistency lowers return rates and strengthens brand recognition — two things every B2B buyer values deeply.
For me as a procurement professional, the real benefit is this:
a factory with a structured customization system can scale with you.
That means:
It’s the difference between a supplier you “use” and a supplier you can grow with.
And trust me — your supply chain will feel lighter, smoother, and far more predictable.

After guiding countless procurement teams through the process of sourcing inflatable gymnastics mats, I’ve learned that speed, stability, and control shape the true competitive advantage behind every successful supply chain.
If you’ve reached this section, it means you already understand one crucial truth:
Lead time isn't a number — it’s a system you can optimize.
Here’s what I always do at this point in a B2B engagement, and these steps consistently determine whether a brand wins its season or stumbles into backorders.
I require my factory partners to provide:
Transparency creates predictability — and predictability creates reliability.
Whether it’s:
Every early confirmation accelerates your production start date.
Using structured systems like customize air tracks can easily save 3–5 days by eliminating revision loops.
I actively:
In B2B procurement, waiting is not a strategy.
Coordination is.
When you put production at the center of your supply chain planning, your mats don’t “wait to be finished.”
They move through the system with intention and precision — the way professional procurement is meant to feel.
When importing inflatable wrestling mats from China, how do you test for air leakage?
2026 Best Air Track Mats for Gymnastics: Complete Buyer's Guide & Training Tips
What Is an Air Track for Gymnastics? The Professional Buyer's Guide
How to Choose Air Tracks for Your Gym Business: Tips from a Trusted Air Tracks Supplier
